Timeline In Excel

What Is Timeline In Excel?

Timeline in Excel is often referred as Milestone Chart in Excel. Projects include multiple phases and tracking the progress of each phase is equally important as the execution of each phase.

Tracking the status of the phases makes the job easy to execute and plan for the next phase of the project. Hence, a milestone chart or Timeline in Excel helps us to manage the project along with the project timelines.

In the timeline chart, each phase of the project shows up and down, and a typical timeline chart in Excel looks as shown in the following image.

Timeline in Excel - Project Milestone Chart

A horizontal line has been drawn in the chart; on top and bottom of this horizontal line, each phase of the project is shown according to the execution time.

The benefits of using timeline in excel or milestone chart are as follows:

Identify major milestones of a project: Milestones are significant in any project and are often referred to as signs or health of the project. By identifying the milestones, we can answer a few questions such as,

  • Are these the significant steps in the project?
  • Are there any additional resources required in this step?
  • If this task doesn’t get finished on time, can we complete the whole project on time or not?
  • Do stakeholders required to take any strict actions in the coming phase of the project?

A timeline or milestone chart helps us to answer all the above questions and help the project managers to keep track of their project deliverables.

In Excel, we do not have a built-in chart for this timeline chart. However, we can create timeline in excel with formatting.

Key Takeaways
  • Timeline in excel charts helps the project manager to look at the progress against the time and take necessary actions.
  • A timeline chart requires a lot of formatting to be done to convert the regular chart into a milestone chart.
  • A timeline slicer was first introduced in Excel 2013 version only for pivot tables.
  • Using timeline in excel slicer, users can filter years, months, quarters, and days.
  • To quickly create an event timeline, we can make use of smart art in Excel.

How To Create Timeline In Excel?

Using timeline in excel, we can create a chart or graphical representation of the tasks of the project. To create a milestone chart, we need to use the following steps.


Excel VBA – All in One Courses Bundle (35+ Hours of Video Tutorials)

If you want to learn Excel and VBA professionally, then ​Excel VBA All in One Courses Bundle​ (35+ hours) is the perfect solution. Whether you’re a beginner or an experienced user, this bundle covers it all – from Basic Excel to Advanced Excel, Macros, Power Query, and VBA.

Step #1 – Setting Up The Data

The first requirement of any graphical representation is to set up the data and the milestone chart is no different here.

First, make a list of tasks or phases in the project with the tentative start date as shown in the following image.

How to create Timeline in Excel - Step 1

The first column is the expected month to complete the project phases. The second column is the phases or activities to be performed in the project.

Once we have listed down all the phases and tentative timelines for each phase, we need to create another helper column here i.e., create positive and negative numbers as shown in the following image.

How to create - Step 1a

Another formatting we need to do is apply the excel date format as MMM YYYY to the date column as shown in the following image.

How to create - Step 1b

Step #2 – Create a Line Chart

The actual process of building a timeline chart begins now. Select any of the cells in the data table, go to the Insert tab and insert the line chart as shown below.

How to create Timeline in Excel - Step 2

We will get a line chart as highlighted in the below image.

How to create - Step 2a

Right click on the chart and click on the Select Data… option.

How to create - Step 2b

The Select Source Data window opens up. Choose Helper from the Legend Entries (Series) and remove it.

How to create - Step 2c

This will make the chart blank. Now, we need to manually reassign the values to the chart. Click on the Add button in the same window.

How to create - Step 2d

In the Edit Series window, choose cell B1 for Series name: and cell range B2:B9 for Series values:

How to create - Step 2e

Click on OK and we are back to the previous window.

Now click on the Edit option under Horizontal (Category) Axis Labels.

How to create - Step 2f

For this axis, the label chooses date values from the range A2:A9.

How to create - Step 2g

Click on OK.

Now we will be back to the data source window. In this window, we need to add another label i.e., helper column values.

Click on the Add button.

How to create - Step 2h

Choose cells from the range C2:C9 for the Series values: option.

How to create - Step 2i

Click on OK in the next two windows and now the chart looks like the following image.

How to create - Step 2j

To convert the preceding chart into a milestone chart, we must now apply formatting to it.

Step #3 – Apply Formatting to the Chart

Select the line chart and press the formatting shortcut key Ctrl + 1 to open the Format Data Series window on the right side.

How to create Timeline in Excel - Step 3

Click on the Fill option and make change the line to no line.

How to create - Step 3a

Except markers, all the lines are disappeared. By selecting the markers go to the Design tab in the ribbon and click on the Add Chart Element option.

How to create - Step 3b

Hover on Error Bars and click on More Error Bars Options… option.

How to create - Step 3c

This will activate the Format Error Bars window on the right side.

How to create - Step 3d

Change the Vertical Error Bar to Minus.

How to create - Step 3e

Scroll down in the same format window and change the Percentage to 100% in the Error Amount category.

How to create - Step 3f

Once again, select the markers and open the Format Data Series window on the right side.

How to create - Step 3g

Click on Series Option and choose the Secondary Axis option.

How to create - Step 3h
How to create - Step 3i

As we can see, we have lines along with markers in the chart.

Select the markers, go to the Design tab under the Add Chart Element, hover on Data Labels and click on More Data Label Options.

How to create - Step 3j

It will open the Format Data Labels window. Select Label Options and expand Label Options.

How to create - Step 3k

Under Label Options, choose Category Name and unselect all other selected items.

How to create - Step 3l

Now, the chart starts to show up the dates as labels. We need to add phase names to the labels.

Right-click on the chart and choose Select Data… again.

How to create - Step 3m

Now, the Select Data Source window opens up. Choose Series 2 and click on the Edit option under Horizontal (Category) Axis Labels.

How to create - Step 3n

Select phase values from B2:B9 for Axis Labels.

How to create - Step 3o

Click on OK.

Now we will see Data Labels as phase names.

How to create - Step 3p

Remove gridlines from the chart.

How to create - Step 3q

Change font names to Times New Roman and font color to Black.

Add chart title as Project Milestone Chart.

And now the chart looks like the following image.

How to create - Step 3r

Replace the marker with triangle shapes as shown in the following image.

Project Milestone Chart - 1

This will make the chart appear as shown below.

Project Milestone Chart - 2
Timeline in Excel - Project Milestone Chart Final
  • There is an alternative way to create the same timeline chart. Follow the same steps as we have followed in the above example till we reach the following chart.
Timeline chart in Excel - Alternate method

Now right-click on the chart and choose Change Chart Type… option.

Alternate method - 1

This will open the change chart type window. Choose column chart for series 2 and line chart for phases.

Alternate method - 2

Set the Gap Width of the data bars to 500%.

Alternate method - 3

Change the bar fill color to no color and the border to black.

Alternate method - 4

Add data labels to the bars as we did in the previous example.

Alternate method - 5

Select the horizontal baseline in the middle of the chart and change the line color to black and solid line. Set the line width to 1.14 pt.

Alternate method - 6

Remove the markers from the same baseline.

Alternate method - 7

Select the date values on the x-axis and change the text to the bottom.

Alternate method - 8

Add the chart title and other cosmetic changes to make it look neat. Now the chart looks like the following image.

Project Timeline Chart

Top Timeline Tools in Excel

The above one is all about the chart of projects or tasks. However, we have another timeline in Excel called Timeline for Pivot Tables.

For instance, we have created the following pivot table summary table.

Timeline in Excel - Pivot Table

The above pivot table shows city-wise monthly sales. For the above pivot table summary, we can insert a timeline and play around with the data.

When we select the pivot table, we will see a separate tab called Pivot Table Analyze.

Under this tab, choose Insert Timeline.

Timeline in Excel - Pivot Table Analyze

The Insert Timelines window opens up. Choose OrderDate in this window.

Timeline in Excel - Insert Timelines

Click on OK and we will have a timeline slicer like the following image.

Timeline in Excel - OrderDate

We have two years and under these two years, we have different months.

As we click on any of the months, it will filter for that particular month. For instance, in the following image we have selected Feb month for the year 2020 and the data will show only for 2020 Feb month.

OrderDate - Feb 2020

Similarly, from the filter in the timeline, we can choose to show timelines like Month, Quarter, Year, Days.

For instance, we will choose QUARTERS for the slicer.

OrderDate - Timeline Filter
OrderDate - Timeline Filter -Quarters

We have a timeline showing only quarters across two different years.

Once the timeline is inserted, we can play around with the timeline tools like Header, Selection Label, Scrollbar, and Time Level.

Timeline Tools

As of now, all the tools are checked, and we can see all the tools on the timeline.

Timeline in Excel - Timeline Tools

In this way, we can play around with the timeline slicer in the pivot table.

Important Things to Note

  • A timeline chart is often referred to as a Milestone chart in Excel.
  • We do not have a built-in chart in Excel.
  • To create a timeline chart, we need to create a helper column which is required to place the phases of the project one after the other.
  • A timeline in the pivot table works as a slicer for date periods.
  • All the tools of the timeline are enabled, by default.
  • A timeline slicer in the pivot table works only for date columns.

Frequently Asked Questions (FAQs)

1. How to Add Timeline in Excel?

Once the pivot table is created, we can add timeline in excel for data related columns. Select any of the cells in the pivot table and under PivotTable Analyze tab, click on Insert Timeline.

Timeline in Excel - FAQ 1

After this choose the required date column from the data table to add timeline in excel.

2. How do I create a multi-project milestone timeline in Excel?

Unfortunately, multiple project milestone chart is not yet available in Excel. Even to create a single milestone, one needs to go through multiple steps and formatting of the chart along with the helper column.

3. How to create an event timeline in Excel?

We can use smart art to quickly create an event timeline in excel. Go to the Insert tab and click on the drop-down list of Illustrations and choose Smart Art.

Timeline in Excel - FAQ 3

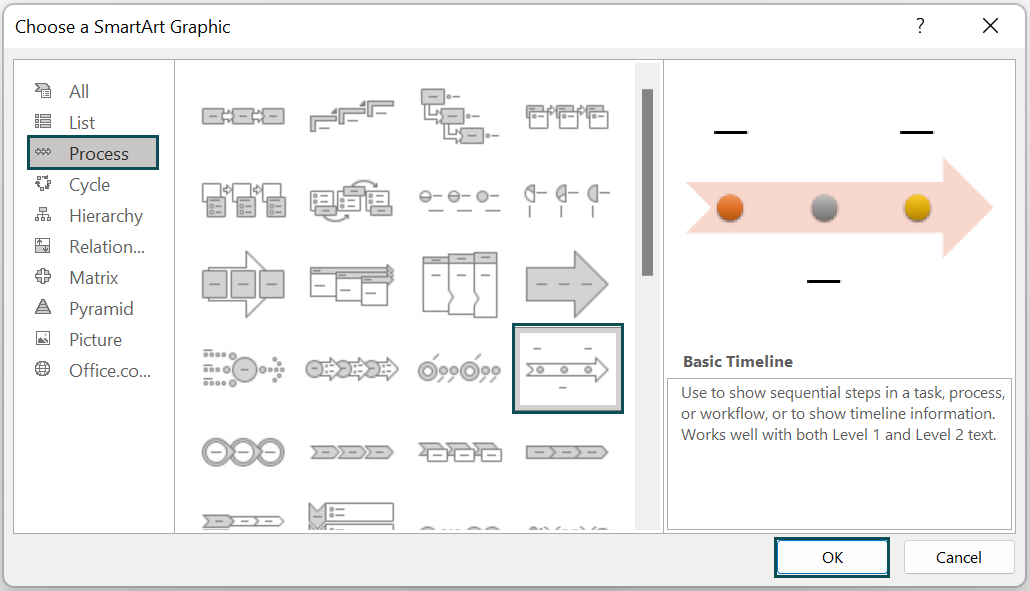

From the smart art, graphics choose the Basic Template under the process option.

FAQ 3-1

This will create a quick flow chart graphic. We can now enter our project tasks.

FAQ 3-2

FAQ 3-3

Download Template

This article must be helpful to understand the Timeline in Excel, with its formula and examples. You can download the template here to use it instantly.

This has been a guide to Timeline in Excel. Here we learn how to create Timeline Chart, use Timeline tools with examples & a downloadable Excel template. You can learn more from the following articles –
